Monthly Operating Review Pack

A six-page operating review that replaces a long status pack with a concise explanation of performance, four material exceptions, three decisions and named follow-up actions.

Project previewOpen full image

The meeting had too much status and too little choice

The December review begins with four exceptions and three decisions.

A multi-site wholesale and service company reviews sales, margin, supplier quality and workforce capacity each month. The managing director, finance director, operations director and workforce lead need to know what changed before they discuss the detail.

The reporting owner applies documented materiality rules, asks the named managers for an explanation and prepares a six-page review. The meeting decides whether to intervene, who must act and what returns at the next review.

The January plan cannot be fixed until leadership decides whether to start the SUP-024 recovery review, pause new London discount approvals and use temporary capacity for service engineers.

A PowerPoint review in six pages

The PowerPoint leads the meeting. The workbook supports it.

The presentation contains the concise leadership story. The Excel review workbook contains all twenty metrics, the detailed records, rules, owners and reconciliations.

The working PowerPoint

The six-page PPTX includes a cover, a December position slide and the supplier trace slide that supports the first leadership decision.

  1. 01

    Position

    What changed and why the meeting needs attention.

  2. 02
    Scorecard

    Twenty metrics, with only the important movement promoted.

  3. 03
    Exceptions

    Four matters crossing a documented materiality rule.

  4. 04
    Evidence

    The supplier records behind the 46-hour headline.

  5. 05
    Decisions

    Three questions with sponsors and needed-by dates.

  6. 06
    Actions for January

    Named follow-up work and the limits of the example.

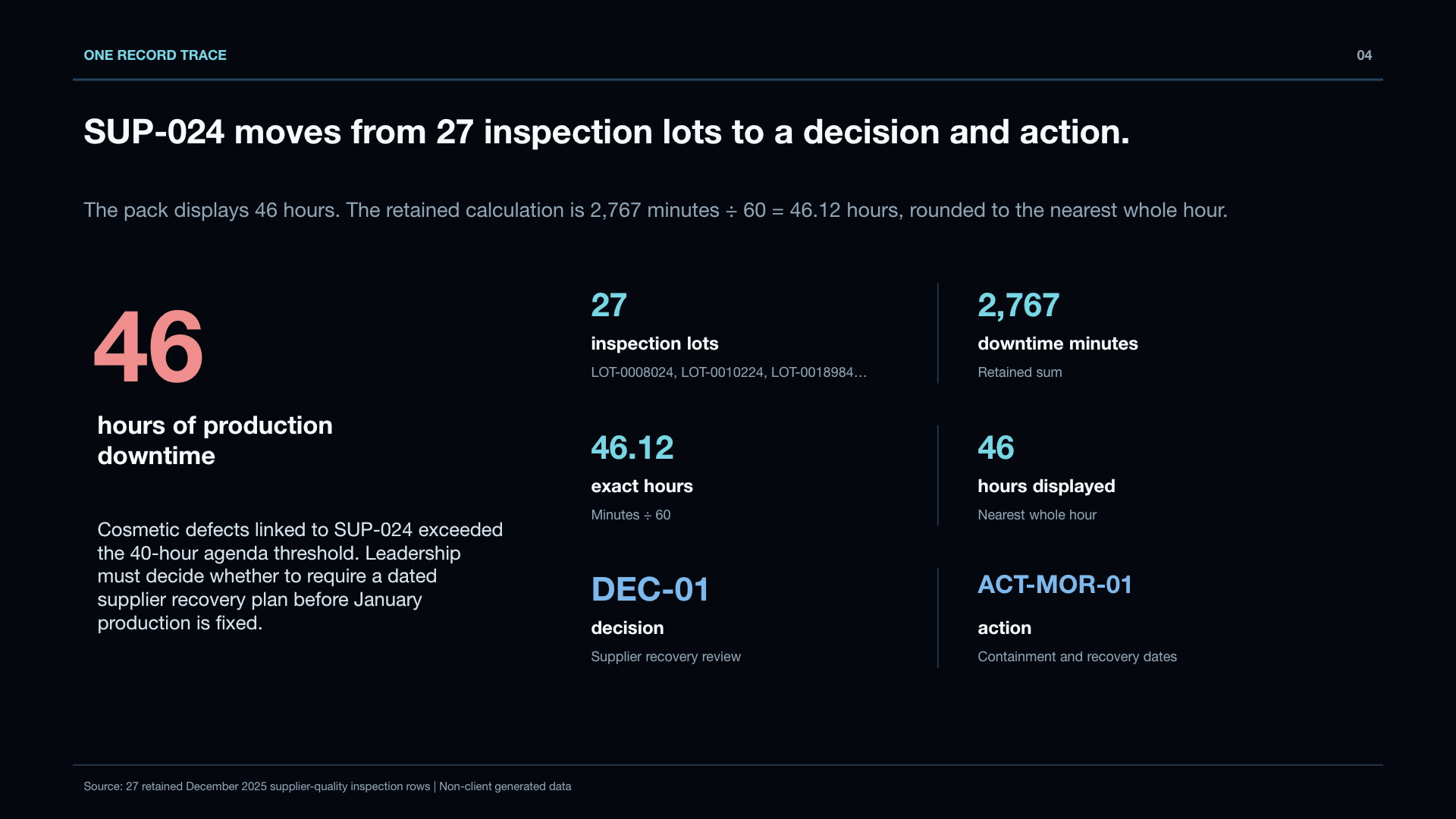

One exception, from records to action

Supplier SUP-024 caused 2,767 downtime minutes in December.

Twenty-seven saved inspection lots record cosmetic defects from supplier SUP-024. Their downtime values sum to 2,767 minutes, or 46.12 hours. The pack shows 46 hours after rounding to the nearest whole hour.

Because the result exceeds the 40-hour agenda threshold, the operations director asks leadership to approve a supplier recovery review. The supplier manager must then confirm the affected parts, containment and recovery dates by 16 January.

Source set
27 December inspection rows
Decision
DEC-01
Action
ACT-MOR-01
Workbook rows
27

SUP-024 exception bridge

27 workbook rows become 2,767 minutes, then one leadership decision and one carried action.

Inspection lots27

Cosmetic-defect records across PLANT-02, PLANT-04, PLANT-06 and 4 affected parts.

Downtime46.1 hours

2,767 minutes, displayed as 46 hours under the rounding rule.

DecisionDEC-01

Approve a supplier recovery review for SUP-024 before the January production plan is fixed?

Carried actionACT-MOR-01

Confirm affected parts, containment and supplier recovery dates.

233cosmetic defects in the saved lot rows
  1. LOT-0055544PLANT-02

    PART-0144 · 2025-12-19

    196 min
  2. LOT-0032144PLANT-02

    PART-0144 · 2025-12-11

    195 min
  3. LOT-0060664PLANT-04

    PART-0064 · 2025-12-22

    188 min
  4. LOT-0100144PLANT-04

    PART-0144 · 2025-12-28

    188 min
  5. LOT-0076744PLANT-04

    PART-0144 · 2025-12-20

    180 min

Follow one supplier exception

LOT-0008024 remains identifiable from its source row to the January action.

This individual lot is one member of the 27-row supplier exception. Its key, inclusion rule, contribution, reviewer decision and named follow-up all come from the saved workbook and check results.

  1. 01

    Inspection lot

    LOT-0008024 records 397 inspected units, 14 cosmetic defects and 27 downtime minutes at PLANT-02.

    plant-02_supplier_quality_2025_12.csv · 14 December 2025
  2. 02

    December membership

    The build selects the typed inspection date, supplier SUP-024, Cosmetic defect type and an empty edge-case field.

    Included in TRACE-SUP-024-2025-12
  3. 03

    Exception calculation

    27 minutes contributes to 2,767 minutes across 27 saved lots. The pack divides by 60 and displays 46 hours after rounding to the nearest whole hour.

    EX-01 · threshold above 40 hours
  4. 04

    Leadership decision

    Approve a supplier recovery review for SUP-024 before the January production plan is fixed?

    DEC-01 · Operations Director
  5. 05

    Named follow-up

    Confirm affected parts, containment and supplier recovery dates.

    ACT-MOR-01 · due 16 January 2026
Open all 27 lot keys
  1. LOT-0008024PLANT-0227 min
  2. LOT-0010224PLANT-0697 min
  3. LOT-0018984PLANT-0623 min
  4. LOT-0025584PLANT-0694 min
  5. LOT-0032144PLANT-02195 min
  6. LOT-0037264PLANT-04152 min
  7. LOT-0048224PLANT-024 min
  8. LOT-0055544PLANT-02196 min
  9. LOT-0057744PLANT-0679 min
  10. LOT-0058464PLANT-0684 min
  11. LOT-0060664PLANT-04188 min
  12. LOT-0061384PLANT-04146 min
  13. LOT-0062864PLANT-02140 min
  14. LOT-0073824PLANT-0668 min
  15. LOT-0076744PLANT-04180 min
  16. LOT-0081864PLANT-06143 min
  17. LOT-0088424PLANT-0244 min
  18. LOT-0090624PLANT-06105 min
  19. LOT-0096464PLANT-025 min
  20. LOT-0097944PLANT-0618 min
  21. LOT-0098664PLANT-0675 min
  22. LOT-0100144PLANT-04188 min
  23. LOT-0103064PLANT-02132 min
  24. LOT-0109624PLANT-0496 min
  25. LOT-0111824PLANT-02168 min
  26. LOT-0119144PLANT-0265 min
  27. LOT-0119864PLANT-0255 min

Why these four matters are in the pack

Each exception crosses a rule and changes a decision or follow-up.

  1. 01

    46 hours of cosmetic-defect downtime linked to supplier SUP-024

    Supplier-related downtime exceeds 40 hours in the month.

    Supplier Quality Manager

    Decision DEC-01

  2. 02

    London gross margin fell 4.6 percentage points

    Regional gross-margin movement exceeds 4.0 percentage points month on month.

    Finance Business Partner

    Decision DEC-02

  3. 03

    26 of 60 service engineer positions were vacant

    A critical role family has more than 35% of positions vacant.

    Workforce Planning Lead

    Decision DEC-03

  4. 04

    A prior operating action remained open beyond its target date

    Any action from a prior review that remains open after its agreed target date is carried forward.

    Operations Improvement Lead

    Carried into January

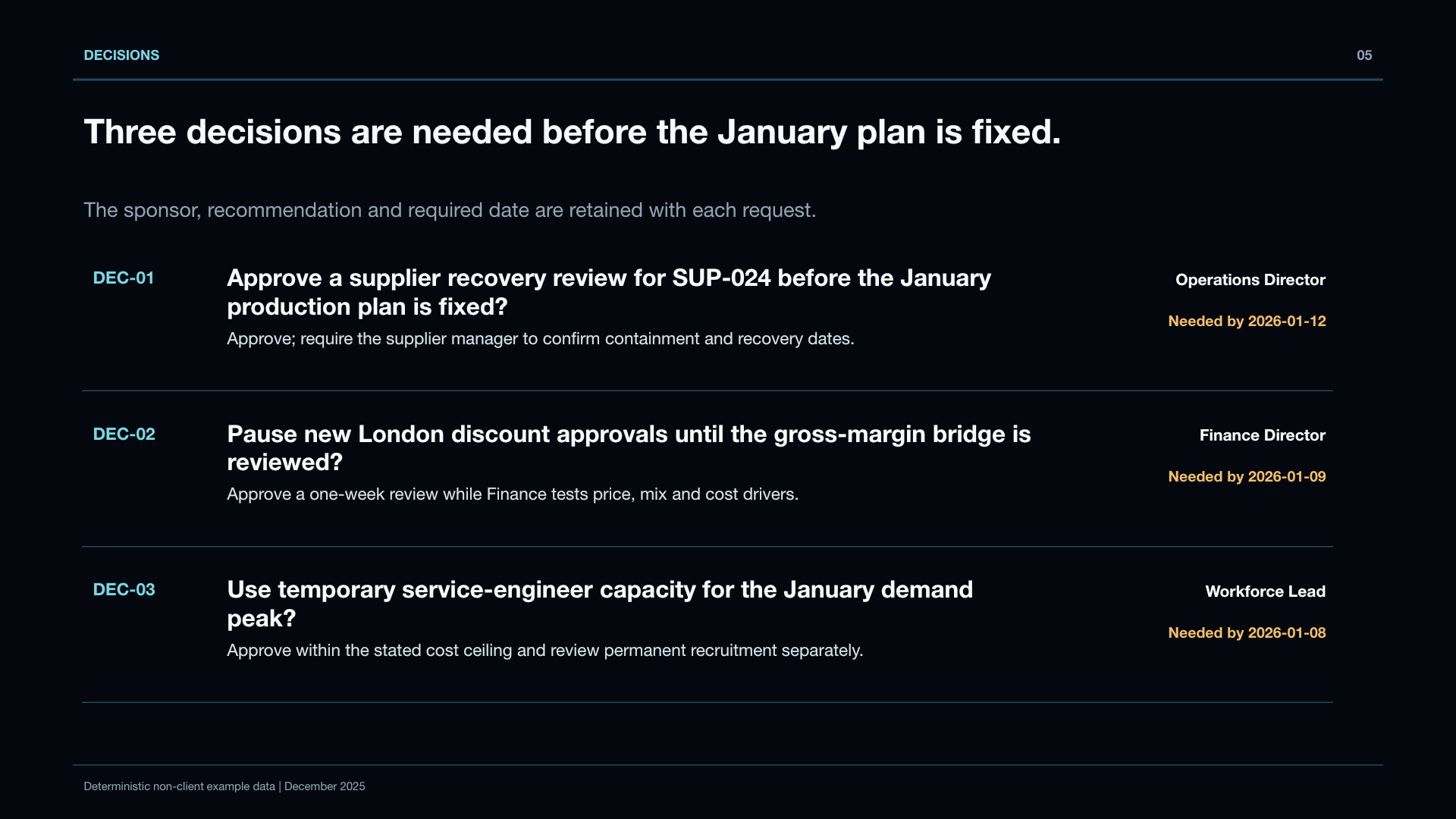

The questions put to leadership

Three decisions have a recommendation, sponsor and required date.

  1. DEC-01

    Approve a supplier recovery review for SUP-024 before the January production plan is fixed?

    Approve; require the supplier manager to confirm containment and recovery dates.

    Operations Director

    Needed by 12 January 2026

  2. DEC-02

    Pause new London discount approvals until the gross-margin bridge is reviewed?

    Approve a one-week review while Finance tests price, mix and cost drivers.

    Finance Director

    Needed by 9 January 2026

  3. DEC-03

    Use temporary service-engineer capacity for the January demand peak?

    Approve within the stated cost ceiling and review permanent recruitment separately.

    Workforce Lead

    Needed by 8 January 2026

The detail stays available

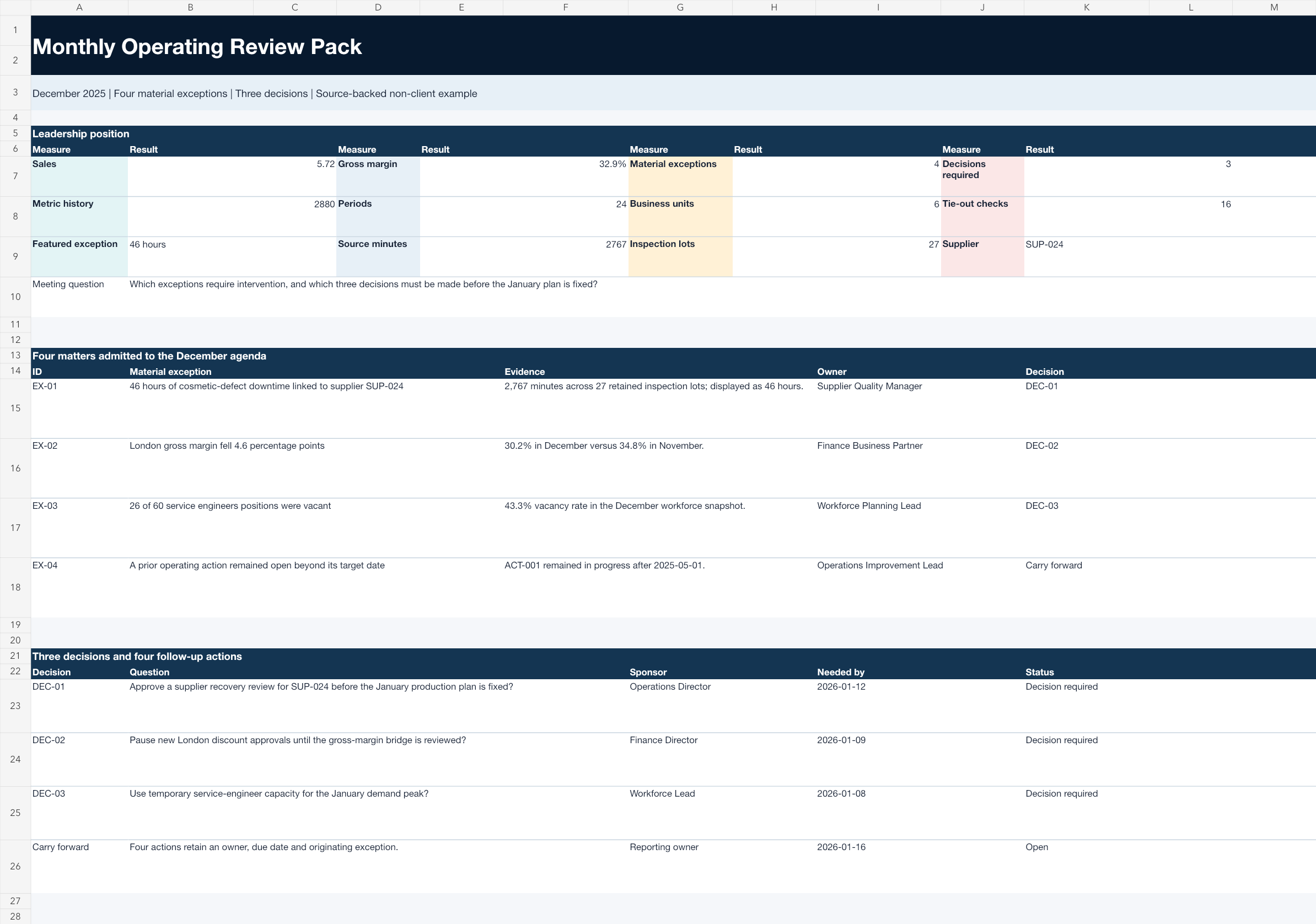

The review workbook connects every headline to records and rules.

Nine workbook sheets hold the monthly review, supplier detail, scorecard, exceptions, decisions, actions, data register, calculation checks and 2,880 metric results.

Included Excel workbook

The workbook holds the detail behind the six-page presentation. It includes the data seed, record counts, checksums and calculation rules for inspection.

Measured scale and validation

The displayed values come from the verified build records.

100,000underlying operating records
2,880metric results
24monthly periods
16 / 16workbook checks pass
  1. 01

    Twenty scorecard metrics are present across twenty-four periods and six business units.

  2. 02

    Every exception has a materiality rule, evidence, consequence and accountable role.

  3. 03

    Every decision has a sponsor, recommendation and required date.

  4. 04

    Every action links to the exception and decision that created it.

  5. 05

    The 27 supplier inspection rows total 2,767 downtime minutes.

  6. 06

    The displayed 46 hours follows the stated rule of rounding to the nearest whole hour.

The workbook, 6-slide PowerPoint and 6-page PDF were rendered and checked against the saved figures. The website images match the corresponding document pages.

Data and limits

Example records show the method without implying client results.

Example records prepared for a December 2025 operating review. Not client work. The saved sales, supplier-quality, operating, action and workforce records cover 24 periods from January 2024 to December 2025.

Technical detailsView the data, rebuild steps and detailed limits

Seeds, checksums, record counts and date ranges are saved with the project. It is not connected to a live ERP, quality or workforce system and does not claim board use, realised savings or control effectiveness.

  • Example records prepared for a December 2025 operating review. Not client work.
  • The build does not demonstrate scheduled refresh, access control, alert delivery or a production approval workflow.
  • The materiality thresholds are example rules and would require approval and calibration for an organisation's risk appetite.
  • Twenty-six of the 27 featured supplier rows have a generated source-file month label that differs from the typed inspection date. The review filters on the validated inspection_date field; a live intake should quarantine or correct those labels.
  • The displayed 46 hours is the nearest-whole-hour presentation of 2,767 downtime minutes, or 46.12 hours before rounding.
  • The example does not claim board use, leadership adoption, realised savings, improved decisions or control effectiveness.

Next step

Prepare the meeting around material movement and actual decisions.

Start with the pack used in the meeting and the exceptions, decisions or follow-up that are currently hard to see.
