KPI Definitions and Data Quality

Why five reports show different on-time delivery rates

A row-level reconciliation explaining why the SQL reporting mart, Power BI model, Excel management pack, operational extract and manually maintained report show different on-time delivery percentages.

Project previewOpen full image

Five reports disagree

Excel shows 62.86%. Power BI shows 38.38%.

A distributor's reporting analyst, Power BI developer, finance business partner and operations analyst all publish on-time delivery. Their results differ because they count different records and stop the delivery clock at different events.

The metric owner must decide which percentage can be released for the period, why the reports disagree and what must change in each calculation.

Agreed resultUse 38.81% under MET-DEL-001 version 1.1.

Count 3,898 orders received in full by the original promise date from 10,045 eligible delivered orders. Update the four non-reference implementations before the next reports are issued.

The five answers first

The reported percentages only make sense when the fraction is visible.

The reconciliation starts by printing each numerator and denominator, then shows how every reported result changes under the agreed rule: one eligible delivered order, tested against final customer receipt.

Five on-time delivery results moving to the approved ruleThe chart prints the numerator and denominator for five reported results and shows each result moving to the approved order-level final-receipt definition.Reported resultApproved ruleMET-DEL-001 v1.138.81%3,898 / 10,045SQL reporting mart38.81% · 3,898 / 10,045Approved referencePower BI38.38% · 15,900 / 41,433Grain and event dateExcel management pack62.86% · 6,314 / 10,045Formula and event dateOperational extract38.83% · 7,723 / 19,890Population and event dateManually maintained report39.37% · 3,881 / 9,858Timing, filter and staleness
SQL reporting mart38.81%

3,898 / 10,045

Approved result 38.81% · 3,898 / 10,045
Power BI38.38%

15,900 / 41,433

Approved result 38.81% · 3,898 / 10,045
Excel management pack62.86%

6,314 / 10,045

Approved result 38.81% · 3,898 / 10,045
Operational extract38.83%

7,723 / 19,890

Approved result 38.81% · 3,898 / 10,045
Manually maintained report39.37%

3,881 / 9,858

Approved result 38.81% · 3,898 / 10,045
Five reported answers, one signed rule.Excel is high because the first receipt is treated as completion. The approved rule waits until the final customer receipt, then counts the order once.
Approved definitionMET-DEL-001 version 1.1

Eligible orders received in full by the original promise date / eligible delivered orders.

Grain
Order
Date
Final customer receipt
Approved
Director of Operations, 2026-01-05

How the calculation is brought into line

Grain, event date and extract timing explain the disagreement.

The build reads the same order, line and delivery-event records for every report. It recalculates each published percentage before applying the approved order-level final-receipt rule.

Five delivery report results converging through explicit correctionsThe SQL mart, Power BI model, Excel management pack, operational extract and manually maintained report start with different percentages. Formula, grain, date, population, filter and timing changes bring each route to the same approved order-level result.CURRENT REPORTSSQL reporting mart38.81%Power BI38.38%Excel management pack62.86%Operational extract38.83%Manually maintained report39.37%RECALCULATEONE ORDERfinal customer receiptapproved populationBRIDGECALCULATIONevent daterecord grainPOPULATIONcut-off and exclusionsSIGN OFF38.81%approved29,935 delivered orders reviewed · 10,045 eligible orders · zero unexplained residual
  1. 01
    Recalculate five published results

    Retain each formula, grain, date field, population, filter, refresh time, numerator and denominator.

  2. 02
    Compare one approved rule

    Count one delivered order and use its final customer receipt against the original promise date.

  3. 03
    Bridge every difference

    Separate calculation changes from population and cut-off changes.

  4. 04
    Correct and sign off

    All five implementations finish at 3,898 of 10,045 eligible orders.

Independent recalculation

Each percentage shows the fraction and rule that produced it.

SQL reporting mart38.81%

3,898 / 10,045

Counts each eligible delivered order once and waits for the final customer receipt.

Difference
Approved reference
Owner
SQL developer
Refresh
2026-01-03T06:00:00Z
Power BI38.38%

15,900 / 41,433

Counts order lines and tests warehouse dispatch rather than completed delivery.

Difference
Grain and event date
Owner
Power BI developer
Refresh
2026-01-03T06:30:00Z
Excel management pack62.86%

6,314 / 10,045

Counts an order as on time when its first customer receipt meets the promise date.

Difference
Formula and event date
Owner
Finance business partner
Refresh
2026-01-02T17:00:00Z
Operational extract38.83%

7,723 / 19,890

Uses warehouse dispatch and does not require a confirmed customer receipt.

Difference
Population and event date
Owner
Operations performance manager
Refresh
2026-01-03T05:45:00Z
Manually maintained report39.37%

3,881 / 9,858

Uses an early cut-off and removes cancellation-after-dispatch records.

Difference
Timing, filter and staleness
Owner
Management-reporting analyst
Refresh
2025-12-24T17:00:00Z

Excel reconciliation workbook

The workbook shows the numerator, denominator and correction required for each report.

The workbook contains the comparison, percentage bridge, one order trace, the five implementation rules, material record differences, corrected results, validation checks and the input register.

SQL reporting mart38.81%

3,898 / 10,045

  1. Approved calculation already applied0.00 pp

    3,898 / 10,045

  2. Align the eligible order population0.00 pp

    3,898 / 10,045

Approved38.81%

3,898 / 10,045

Power BI38.38%

15,900 / 41,433

  1. Use final receipt at order grain-28.97 pp

    3,898 / 41,433

  2. Align the eligible order population+29.40 pp

    3,898 / 10,045

Approved38.81%

3,898 / 10,045

Excel management pack62.86%

6,314 / 10,045

  1. Use final rather than first receipt-24.05 pp

    3,898 / 10,045

  2. Align the eligible order population0.00 pp

    3,898 / 10,045

Approved38.81%

3,898 / 10,045

Operational extract38.83%

7,723 / 19,890

  1. Use confirmed final receipt-19.23 pp

    3,898 / 19,890

  2. Align the eligible order population+19.21 pp

    3,898 / 10,045

Approved38.81%

3,898 / 10,045

Manually maintained report39.37%

3,881 / 9,858

  1. Restore filtered and late-arriving records+0.17 pp

    3,898 / 9,858

  2. Align the eligible order population-0.74 pp

    3,898 / 10,045

Approved38.81%

3,898 / 10,045

Result produced by the working calculation

The values shown on the page come from the generated delivery records, SQL reconciliation and workbook outputs. The website does not substitute separate illustrative figures.

See exactly how the figures change

Every route reaches 38.81% with no unexplained remainder.

Power BI changes from line-level dispatch to order-level final receipt. Excel changes from first receipt to final receipt. The operational extract adds customer receipt and narrows its population. The manual report restores filtered and late-arriving records. SQL already applies the approved definition.

The agreed change in each report

Every correction has an owner, an affected report and a recorded approval.

The tolerance is 0.0000 percentage points. A report is not aligned while any difference remains.

SQL reporting martApproved reference

Retain the approved order-level final-receipt rule.

Owner
SQL developer
Affected report
Monthly service report
Decision
Approved for this generated sample model
Approved
Director of Operations, 2026-01-05
Power BIGrain and event date

Replace the line-grain dispatch measure with the approved order-grain final-receipt measure.

Owner
Power BI developer
Affected report
Power BI delivery report
Decision
Approved for this generated sample model
Approved
Director of Operations, 2026-01-05
Excel management packFormula and event date

Replace first receipt with final receipt when testing whether the order completed on time.

Owner
Finance business partner
Affected report
Monthly management pack
Decision
Approved for this generated sample model
Approved
Director of Operations, 2026-01-05
Operational extractPopulation and event date

Add final customer receipt and apply the eligible delivered-order population before publishing the metric.

Owner
Operations performance manager
Affected report
Operational delivery extract
Decision
Approved for this generated sample model
Approved
Director of Operations, 2026-01-05
Manually maintained reportTiming, filter and staleness

Refresh after the period closes and remove the manual cancellation filter so the complete approved population is used.

Owner
Management-reporting analyst
Affected report
Manually maintained service report
Decision
Approved for this generated sample model
Approved
Director of Operations, 2026-01-05

One split order explains the rule

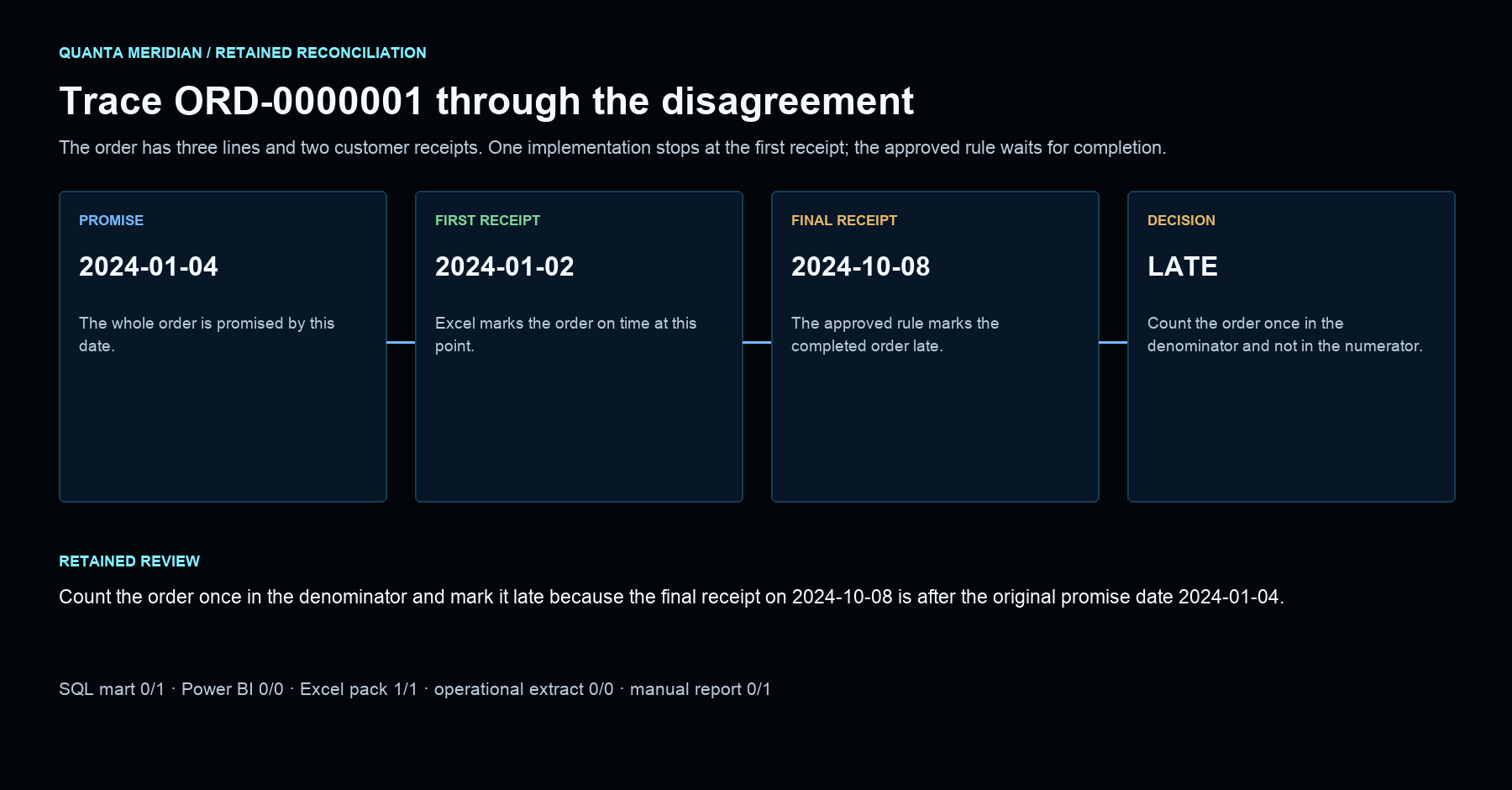

ORD-0000001 is on time in Excel and late under the approved definition.

The order has 3 product lines. Its promise date is 2024-01-04. Excel uses the first customer receipt on 2024-01-02, while the approved rule waits for the final receipt on 2024-10-08.

First receipt answerOn time in the Excel pack

The first customer receipt records 16 units on 2024-01-02, before the 2024-01-04 promise date. Excel adds 1 to its numerator and 1 to its denominator.

Final receipt answerLate under the approved rule

The final receipt records the remaining 18 units on 2024-10-08. The signed rule counts the order once, with denominator 1 and numerator 0.

  1. 01Order promised

    2024-01-04

  2. 02First receipt

    EVT-0000001 · 2024-01-02 · Excel adds 1 to its numerator.

  3. 03Final receipt

    EVT-0120001 · 2024-10-08 · the order is complete after the promise date.

  4. 04Agreed metric decision

    Denominator 1 · numerator 0 · late · Approved for this generated sample model.

SQL reporting mart0 / 1

Late because the final customer receipt is after the original promise date.

Power BI0 / 0

Missing warehouse dispatch event

Excel management pack1 / 1

On time because the Excel management pack uses the first receipt rather than final completion.

Operational extract0 / 0

Missing warehouse dispatch event

Manually maintained report0 / 1

Late because the retained manual report uses final customer receipt for this order.

What was checked

19 of 19 checks passed for the result and the page values.

  • All 120,000 orders, 250,000 order lines and 180,000 delivery events agree with the generated-data manifest.
  • The SQL mart, Power BI model, Excel management pack, operational extract and manually maintained report are independently recalculated from the same source rows.
  • Each route has one numerator, one denominator and three explicit bridge steps to the approved result.
  • The maximum unexplained bridge residual is 0.0000 percentage points.
  • All 5 corrected implementations use 3,898 on-time orders from 10,045 eligible delivered orders.
  • The split-order trace reproduces both the Excel on-time decision and the approved late decision.
Repeatability check

The verification script reruns the calculations and compares 16 outputs byte for byte. It also checks all 9 required workbook sheets and confirms that the bridge has no unexplained remainder.

Data and limits

This example reconciles one delivery measure; it does not describe a real organisation's performance.

The build uses deterministic non-client order and delivery data generated with a fixed seed of 240605. It covers 120,000 orders from 2024-01-01 to 2025-12-21.

Technical detailsView the data, rebuild steps and detailed limits

The data does not describe a real distributor. The DAX definition is included and independently recalculated, but it has not been run in Power BI Desktop. This project reconciles one metric and does not confirm every measure used in the five reports.

  • The deterministic generated records do not measure a real distributor or its delivery performance.
  • The current and approved DAX are independently re-performed but have not been executed in Power BI Desktop.
  • The operational extract and manually maintained report are saved calculation snapshots rather than live connected reports.
